The Fight

Sign In or Create an Account.

By continuing, you agree to the Terms of Service and acknowledge our Privacy Policy

Hotspots

Bad News for Agrivoltaics in Ohio

And more of the week’s top conflicts around renewable energy.

•

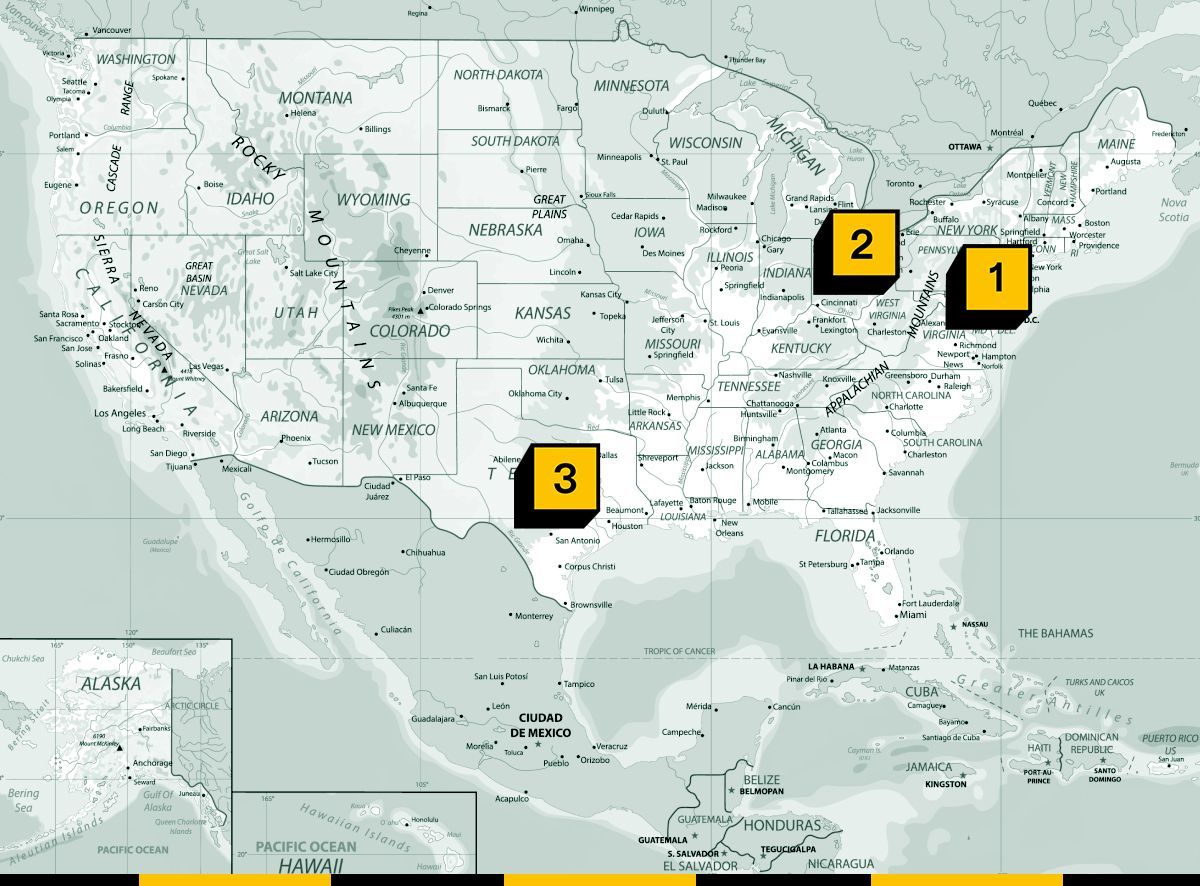

Map of renewable energy conflicts.
Heatmap Illustration

1. Queen Anne’s County, Maryland – They really don’t want you to sign a solar lease out in the rural parts of this otherwise very pro-renewables state.

  • County officials this week issued a public notice encouraging all residents to consider the economic impacts of taking farmland out of use to build solar farms.
  • “The Queen Anne’s County Commissioners are concerned that large-scale conversion of farmland to solar energy facilities may impact the long-term viability of agriculture in the county and surrounding region,” read the notice, which told anyone approached by a solar company about their land to immediately consult an attorney and think about these “key considerations.”
  • “As more farmland is transitioned to solar use, the demand for these agricultural support services diminishes. If enough land is taken out of production, it could create serious challenges for those who wish to continue farming.”
  • It’s not immediately clear whether this was related to a specific project or an overall rise in renewables development that’s happening in the county. But there’s a clear trend going on. Officials said in an accompanying press release that officials in neighboring Caroline County sent a similar notice to property owners. And it seems Worcester County did something similar last month.

2. Logan County, Ohio – Staff for the Ohio Power Siting Board have recommended it reject Open Road Renewables’ Grange Solar agrivoltaics project.

  • The staff report states: “Opposition to the project has been long-standing and unwavering, which is a strong measure of the local opposition to the project. While some local opposition is not uncommon in many power generation siting projects, when observing and documenting considerable opposition filed in this docket, staff recognizes that in this proceeding the opposition has been especially prominent and overwhelmingly one-sided from the local government agencies.”
  • This rejection is particularly striking as Open Road Renewables held multiple listening sessions for the surrounding community, modified its scope in light of the feedback, and claimed that 80% of public comments on the project were supportive. (Heatmap Pro, meanwhile, has Logan in the 99th percentile of the riskiest counties in America to build a clean energy project.)
  • What comes next for Grange Solar? The OPSB will ultimately have to vote on whether to side with its staff, though it rarely votes against. Open Road Renewables will then have the right to appeal this project. It feels unlikely that it’ll meet the company’s 2026 construction start plan.

3. Bandera County, Texas – On a slightly brighter note for solar, it appears that Pine Gate Renewables’ Rio Lago solar project might just be safe from county restrictions.

  • At a county commission hearing this week, Bandera Commissioner Jack Moseley told a room of anti-solar residents that even though he wanted to stop the project, there was no role for him to do so. That’s because, as we explained in our deep dive on Rio Lago, Texas’ state laws are quite weak on local control around solar.
  • “I don’t want it here. I don’t think any of these commissioners want it here, and I don’t think there’s anyone in this room that wants it here. But, we the County cannot stop it,” Moseley said, according to local news outlet Bandera Bulletin.

Here’s what else we’re watching…

In Illinois, Armoracia Solar is struggling to get necessary permits from Madison County.

In Kentucky, the mayor of Lexington is getting into a public spat with East Kentucky Power Cooperative over solar.

In Michigan, Livingston County is now backing the legal challenge to Michigan’s state permitting primacy law.

This article is exclusively
for Heatmap Plus subscribers.

Go deeper inside the politics, projects, and personalities
shaping the energy transition.
To continue reading
Create a free account or sign in to unlock more free articles.
or
Please enter an email address
By continuing, you agree to the Terms of Service and acknowledge our Privacy Policy
Spotlight

A Giant Data Center Offers a Permitting Reform Test Case

What would happen to Project Jupiter if the Bipartisan American Affordability and Jobs Act is passed?

•
Project Jupiter.
Heatmap Illustration/Project Jupiter, Library of Congress

One of the nation’s largest data centers is struggling under permitting woes. So let’s play a game: would the bipartisan permitting bill in Congress make the path easier, or might the federal legislation be irrelevant to large hyperscalers under development today?

Meet Project Jupiter, a mega project in southern New Mexico in Dona Ana County under development by Oracle and OpenAI, with financial backing from SoftBank and political support from the Trump administration for being a part of Stargate, a major Trump administration public-private initiative boosting AI development. Project Jupiter would be one of the largest data centers in the country if completed and currently is expected to run on a microgrid powered by fuel cells converting gas to electricity, which the developers claim will burn much cleaner than a typical off-grid gas turbine power plant.

Keep reading...Show less
Yellow
Hotspots

The Trump Administration Is Still Messing with Offshore Wind Farms

And more of the week’s top news around project fights.

•

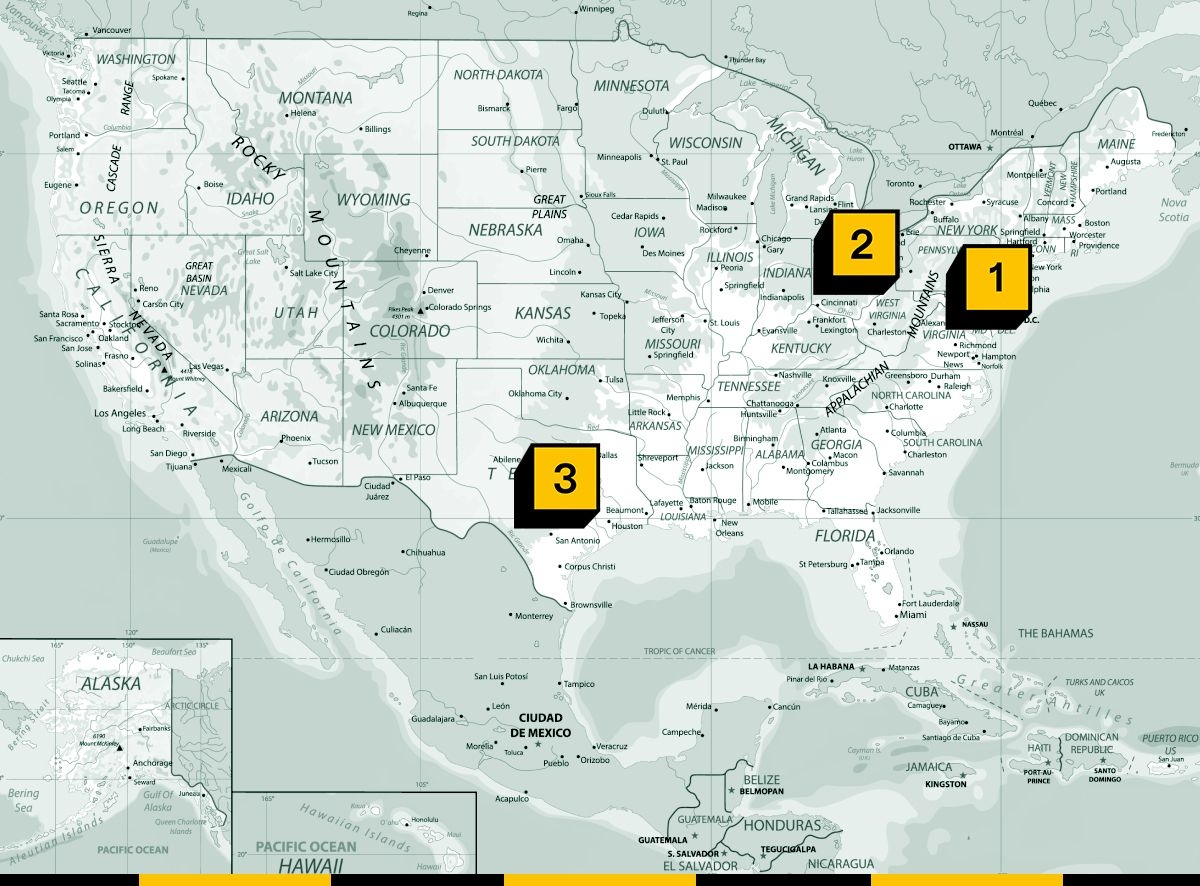

The United States.
Heatmap Illustration/Getty Images

1. New England (and Maryland) – The Trump administration is still messing with offshore wind farms, even while trying to pass a permitting reform deal. Examining the court filings reveals why they may feel empowered to do it — and I’m not sure how this ends.

  • Last Friday, in a legal case brought by anti-wind activists, the Justice Department submitted a motion in federal court to send the construction and operations plan for Orsted’s Revolution Wind project in New England back to the Interior Department for more analysis. On Wednesday, the DOJ entered a similar motion in another case challenging the construction and operations plan for U.S. Wind’s MarWin project off the coast of Maryland in a lawsuit brought by the state’s coastal community of Ocean City.
  • Trump’s actions led some to question whether the president was sabotaging the deal, and others to claim the media coverage itself was an attempt to kill it. Going further, supporters of the bipartisan bill claimed the DOJ's motions were precisely why the bill should become law, implying it would guard offshore wind farms against this sort of maneuver.
  • However, for the bill’s backers, it’s worth considering why the Trump administration believes it has the legal authority to do this. It’s also time to ask whether the bill would actually protect these wind farms against this tactic.
  • To answer those questions, you have to rewind. On May 1, 2025, the Interior Department withdrew a Biden solicitor’s opinion instructing the agency to “strike a rational balance” between wind power and fishing interests. This revocation document is technically not in effect at the moment; one year later, a federal court ruled the opinion was potentially illegal as a part of a preliminary injunction on five anti-renewables actions requested by solar and wind trade groups. The Trump administration is contesting that ruling, and the administration has filed a notice of appeal.
  • In August, despite that opinion being in doubt, a federal judge granted Trump permission under the Outer Continental Shelf Lands Act to remand the construction and operations plan for the now-defunct Atlantic Shores offshore wind farm in the waters of New Jersey. U.S. District Judge Jia Cobb specifically wrote that Atlantic Shores failed to demonstrate the federal government had limitations under OSCLA on revisiting these plans and that the injunction from the litigation on appeal “did not prohibit all reevaluation of agency action.”
  • In the recent Revolution and MarWin filings, Trump’s Justice Department argues the construction and operations plans should be remanded under OSCLA without being vacated. The DOJ motions include claims that previous decision documents did not adequately explain impacts to commercial fishing and other industries that use OSCLA waters. It’s not clear if the administration will win these motions.
  • The bipartisan permitting bill would bar the Interior Department and other federal agencies from taking “any new action that would revoke, rescind, withdraw, terminate, suspend, amend, or alter a federal authorization or permit in effect on or after September 16, 2026,” or “any other action to interfere with or prevent the construction or operation at full capacity of a project that has secured all necessary federal authorizations and permits.” The restriction exempts cases where “the agency is required to take such action by order of a court.” As I wrote in our lengthy piece explaining the bill, this provision has a damages component that allows companies impacted by violations to pursue financial compensation.
  • Here’s the billion-dollar question I expect we won’t have answered unless the bill language is enacted and then litigated: Would the court order exception apply to rulings that grant these motions? Or would the developers be able to sue for damages?

2. Columbia County, N.Y. – New York’s renewable energy permitting office has rejected an upstate solar farm on farmland as a House Democrat representing the area joined hands with the Trump administration in publicly railing against the project.

Keep reading...Show less
Yellow
Q&A

The Developer that Builds Local Support with ‘Right-sized’ Data Centers

A conversation with Harmol Samra of Host Digital

•
The Q&A subject.
Heatmap Illustration

This week’s conversation is with Harmol Samra, CEO of data center developer Host Digital. I asked Samra for a conversation because his team expressed a willingness to offer candid views on the industry’s problems with social license to operate — namely, why is the industry botching this so badly? From his point of view, many could learn a lot from industrial revolutions of the past, and they should be careful not to let mega-project expansions get in the way of broader acceptance of the data center sector.

The following conversation was lightly edited for clarity.

Keep reading...Show less
Yellow
