The Fight

Sign In or Create an Account.

By continuing, you agree to the Terms of Service and acknowledge our Privacy Policy

Hotspots

Trump Administration to ‘Reconsider’ Approval for MarWin

And more of the week’s most important conflicts around renewable energy.

•

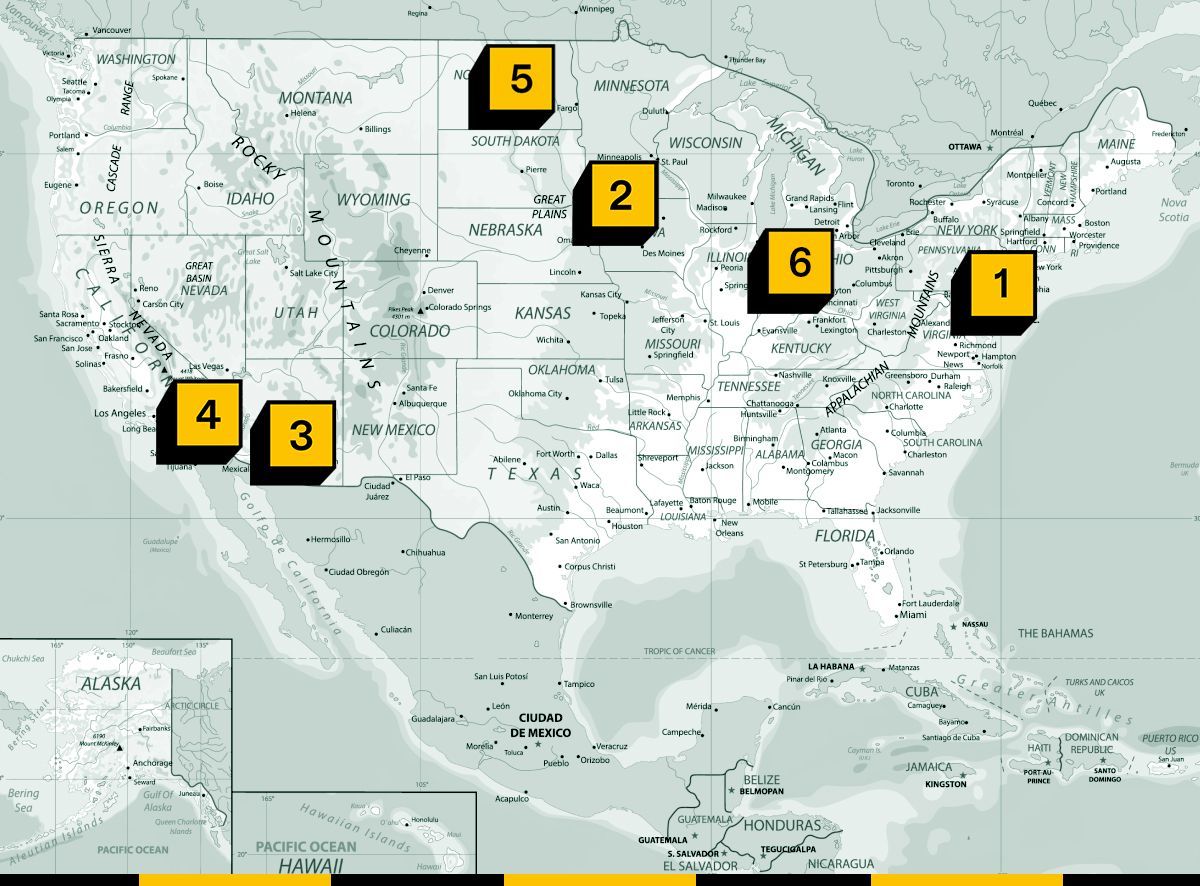

The United States.
Heatmap Illustration/Getty Images

1. Sussex County, Delaware – The Trump administration has confirmed it will revisit permitting decisions for the MarWin offshore wind project off the coast of Maryland, potentially putting the proposal in jeopardy unless blue states and the courts intervene.

  • Justice Department officials admitted the plans in a paragraph tucked inside a filing submitted to a federal court in Delaware this week in litigation brought by a beach house owner opposed to the offshore wind project.
  • DOJ stated in the filing that more time was “necessary as Interior intends to reconsider its [construction and operations plan] approval” for MarWin, and that it plans to “move” for “voluntary remand of that agency action” in a separate case filed by Ocean City, Maryland against the project.
  • “The outcome of Interior’s reconsideration has the potential to affect the Plaintiff’s claims in this case,” the filing stated. “Continuing to litigate this case before any decision is made in the [Ocean City case] would potentially waste considerable time and resources for both the parties and the Court.” As of today, no new filings have been made in the Ocean City case.

2. Northwest Iowa – Locals fighting a wind project spanning multiple counties in northern Iowa are opposing legislation that purports to make renewable development easier in the state.

  • Both chambers of the Iowa legislature appear to be advancing an effort to streamline renewable permitting at the state and local level. Both versions of the bill – HSB 317 in the House and SF 376 in the Senate – would among other things create restrictions on local setback distances and standards on what guidelines municipalities can put in place against renewables projects.
  • Subcommittees in both chambers have recommended passage of the bills. It is unclear at the moment whether either of them stand a chance at becoming law soon, though it is altogether notable to see this effort gain traction in the Midwest.
  • Despite this uncertainty, the bills are reportedly becoming an issue in areas like Dickinson County, where some residents are fighting Invenergy’s Red Rock Wind Energy Center. I first learned about this effort because landowners against Red Rock now claim the setback restrictions in the bills would be insufficient to preserve their “property rights.”

3. Pima County, Arizona – Down goes another solar-powered data center, this time in Arizona.

  • Residents in Tuscon successfully defeated an Amazon proposal to build “Project Blue,” a hulking data center project. Tucson’s city council unanimously directed its staff to halt work on the project citing concerns about water use and energy demand.
  • According to public documents, Project Blue was itself proposed in Tuscon because it would get access to the region’s mix of renewable energy generation. The project would purportedly also include the construction of new solar-and-storage facilities to help power operations.

4. San Diego County, California – A battery storage developer has withdrawn plans to build in the southern California city of La Mesa amidst a broadening post-Moss Landing backlash over fire concerns.

  • EnerSmart, the developer of the project, told local media it rescinded the plans last week because of concerns about a transmission bottleneck. However, some of those fighting battery storage across the state have publicly taken credit for the decision and claim it was the product of community meetings with La Mesa.
  • “It was right next to homes, in close proximity to a school and conveniently positioned directly across the street from a substation,” wrote Kendra Correia, an activist who has fought other battery projects north of San Diego, in a Facebook post. “This community rallied together, met with local government leaders, gained media attention and campaigned against the placement of this facility, that would endanger their community. Congratulations!”

5. Logan and McIntosh Counties, North Dakota – These days, it’s worth noting when a wind project even gets approved.

  • North Dakota’s Public Service Commission approved Orsted’s Badger wind farm, which will span two counties in a southernmost stretch of the state. It did so despite the Federal Aviation Administration apparently denying the use of advanced lighting alerts for about half of the turbines.
  • The project will apparently complete construction before the end of 2025, which means it may ultimately still be able to qualify for tax credits under the Inflation Reduction Act.

6. Hamilton County, Indiana – This county is now denying an Aypa battery storage facility north of Indianapolis despite growing power concerns in the region.

  • Apparently, like many other places in the U.S., concerns about battery fires won out. Chemical worries also abounded, with at least one resident reportedly saying in the public hearing on the project that they’re worried about tornadoes picking up batteries.
  • Hamilton has an incredibly high renewable energy support score – but its opposition risk is just as high in the Heatmap Pro database. The reasoning? A powerful mixture of political resentment and a high population density.
Yellow

This article is exclusively
for Heatmap Plus subscribers.

Go deeper inside the politics, projects, and personalities
shaping the energy transition.
To continue reading
Create a free account or sign in to unlock more free articles.
or
Please enter an email address
By continuing, you agree to the Terms of Service and acknowledge our Privacy Policy
Hotspots

Meta Data Center Federal Pipeline Review Due Early Next Year

And more of the week’s top fights around development.

•
The United States.
Heatmap Illustration/Getty Images

1. Richland Parish, Louisiana – Gird your loins for the coming fight over the Meta Hyperion data center’s gas pipeline.

  • On Wednesday, the Federal Energy Regulatory Commission laid out plans for an environmental assessment of the Entergy pipeline for the Meta data center under the National Environmental Policy Act and stated it’ll be issued in early January 2027. Federal agencies have been ordered by the panel to complete any remaining decisions on authorizations by April.
  • The decision to do an environmental assessment under NEPA will be controversial. The Sierra Club filed comments to FERC stating they wanted an environmental impact statement instead that took into account the environmental impacts of the data center being fed by the pipeline, as well as a review of the project’s cumulative impacts, as the activist group said they’re explicitly linked to the data center’s operations. “The power stations and data center are not remote or speculative developments unrelated to the proposed action,” their comments read.
  • This is quite similar to what’s playing out with the Green Chile pipeline in New Mexico for Oracle and OpenAI’s Project Jupiter, which we recently explained could turn into litigation with high stakes for future gas pipelines linked to data centers. But to me, this conflict with Meta feels like it has more at stake for this individual project, as it’s playing out while construction on gas power plants for the data center has been underway for almost a year after earlier being blessed by state regulators.
  • I asked Sierra Club what could happen next. Eric Huber, one of their managing attorneys, told me on Thursday, “I heard the EA is expected in January, but we are in wait and see mode and will decide on further steps when it comes out.” Meta and Entergy did not respond to a request for comment.

2. Spartanburg County, South Carolina – I have one last data center race to tell you to watch on Tuesday: South Carolina’s 4th, on the northern rim of the state.

Keep reading...Show less
Yellow
Plus

Is the Election Really About Data Centers?

Talking with Kevin Gundersen, the head of public affairs for Digital Realty.

•
Kevin Gundersen
Heatmap Illustration

This week’s conversation is with Kevin Gundersen, head of public affairs for data center developer Digital Realty. On Wednesday, Digital Realty released a fascinating poll as part of Infrastructure for America, a pro-data center organization that also includes Compass, Vantage Data Centers, and QTS. The poll pushed back on the idea that we’re currently in the middle of a “data center election”; instead, it found most voters are not expected to choose their national elected officials based on a politician’s stance on data centers.

I reached out to folks involved in the poll's release, and they put me in touch with Gundersen, whom I’ve met before and consider to be a straight shooter. He accepted my invitation to do a candid hot-seat chat about the findings, his thoughts on all the data center attack ads, and whether his industry’s actually recovering any ground with the American people.

Keep reading...Show less
Yellow
Spotlight

Trump Hasn’t Been Advancing New Wind Farms During Permitting Talks

Only upgrades for pre-existing wind projects have been approved.

••
Donald Trump.
Heatmap Illustration/Getty Images

In September, the Trump administration told a reporter that the president directed the Pentagon to finally process wind projects through routine airspace approvals as required under a court order. By doing this, it created the appearance of real headway and good faith in talks with Democrats in Congress on energy permitting legislation before the November midterm elections.

But the White House’s assurances are not what they seem.

Keep reading...Show less
