Exclusive: Over 530 Local Laws Now Seek to Ban or Restrict Data Centers in U.S.

The overwhelming majority of the ordinances were enacted this year, a Heatmap Pro review shows. They’re helping to drive an unprecedented surge of data center cancellations.

•
Local laws restricting or banning data centers.
Heatmap Illustration | Unsplash

America’s data center backlash is gaining steam.

Anti-data-center protesters briefly interrupted President Trump’s speech at a General Motors facility in Michigan earlier this week. A day later, the country music legend Willie Nelson called on Americans to “fight against data centers invading our land.”

Washington has yet to pass major data center regulation. But the backlash is already reshaping local zoning and land use codes across the country, according to an extensive review of public records conducted by Heatmap Pro. A surge of new restrictions and bans have killed dozens of proposed data centers this year.

More than 500 counties or municipalities now actively restrict or block new data centers, according to the review. This tally includes only the most severe constraints — such as steep setback requirements, impossible noise limits, or outright bans on permit approvals — that all but forbid the construction of a data center.

The overwhelming majority of these restrictions have been enacted since the beginning of the year. Nearly 190 have been passed since June 1.

The pace of moratoriums is “accelerating,” Peter Freed, a founding partner at the Near Horizon Group and the former director of energy strategy at Meta, told me.

Broadly, these new local restrictions seem to be succeeding. More than 50 data centers have been canceled so far this year after facing local pushback of some kind, according to a Heatmap Pro review of press accounts, public records, and project cancellations.

That’s more than twice as many projects as were canceled under similar circumstances in all of 2025, according to our data. Eight projects were canceled in July alone.

Ominously for developers, the rate of projects facing cancellations seems to be increasing over time.


More than 200 pending data center projects are now being fought at the local level nationwide. This could mean that a project faces lawsuits, physical protests, contentious public hearings, or an ad campaign.

About 430 data center projects have been contested over the past five years, including the roughly 200 that are currently being fought, the data shows. Roughly 40% of data center projects that faced some kind of local challenge over that period were eventually canceled, according to Heatmap Pro data.

But that figure has gone up in recent months. Today, a data center project that’s challenged by local activists has about a 50% chance of being canceled. A contested data center now has roughly the same odds as a contested solar or wind farm of getting canceled, Heatmap Pro data suggests.

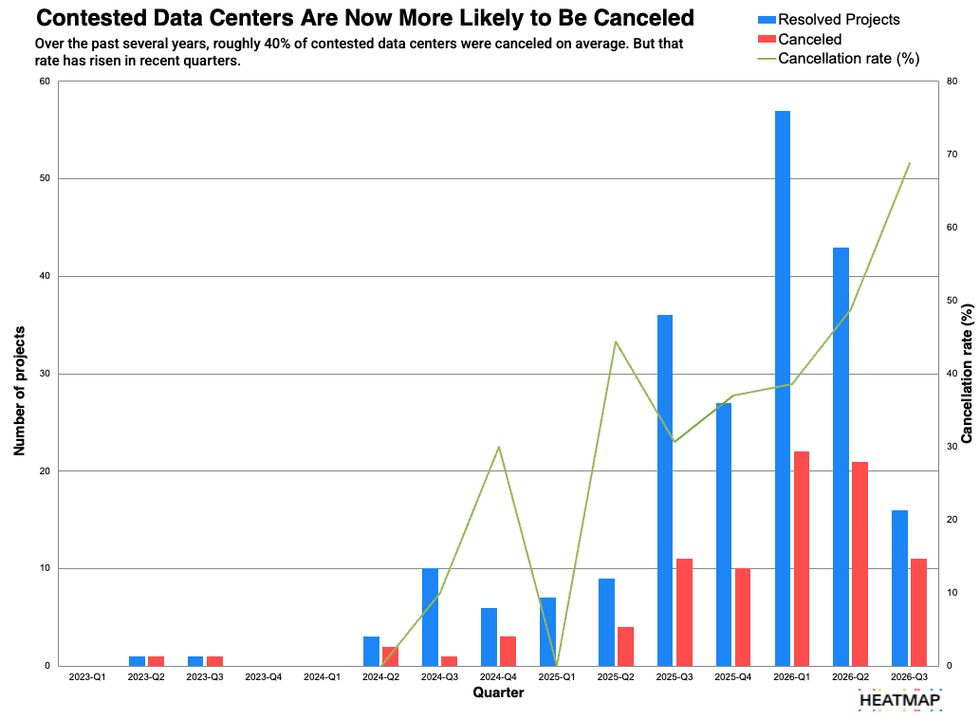

Combination bar-and-line chart showing quarterly outcomes for contested data centers from 2023 Q1 to 2026 Q3. Project resolutions and cancellations rise sharply after 2025, while the cancellation rate\u2014historically around 40%\u2014climbs in recent quarters, reaching nearly 70% in 2026 Q3. The largest project volume occurs in 2026 Q1, with about 57 resolved projects and 22 cancellations.

Data center proposals of every size have faced major delays and cancellations this year. Earlier this month, a sprawling campus that would have built 37 data center buildings near Manassas National Battlefield Park in Virginia was canceled after sustained local protest.

Even the economy’s largest companies have abruptly withdrawn major projects following opposition. Amazon, Microsoft, and Google each canceled large-scale proposals after sustained pushback in Arizona, Wisconsin, and Indiana in the past year. Susan Li, the chief financial officer at Meta, described the infrastructure building environment as “dynamic and uncertain” on a quarterly earnings call this week.

Some analysts have cautioned that the worsening development environment — and snarled supply chains — could imperil the overall artificial intelligence boom. Earlier this year, a JPMorgan report warned that 60% of data center capacity slated to open in 2027 had yet to start construction as of early June.

“Even the major developers are having trouble with projects, but you always have trouble with projects,” Freed said. The question is whether developers have enough proposals in their pipeline to keep up with surging demand, he said.

“I think the answer is mostly still yes. But it’s getting harder to find,” he added. “The impact is increasingly that developers are stopping efforts in those communities [that pass restrictions] and shifting their attention elsewhere.”

State-to-state cancellation rates can vary significantly. Some 71% of contested data center proposals in Michigan are eventually canceled, as are 56% of challenged projects in Indiana, according to Heatmap Pro data.

By comparison, about 17% of challenged data center projects in Texas are canceled.

Polling suggests that Americans want much more strict data center regulation than is in place right now. About six in 10 Americans would support a data center moratorium at the national, state, or local level, according to Heatmap Pro polling.

Majorities of self-identified Democrats and MAGA Republicans would support a ban at all three levels of government. So far only one state, New York, has adopted a moratorium on new data center permit approvals. That one-year ban is not included in this survey of county and municipal restrictions.

Why moratoriums matter

The hundreds of laws restricting data centers may not be a permanent feature of U.S. land use laws. Many of the ordinances are — at least on paper — set to expire in the coming year to give local officials time to create their own schemes for regulating data centers in the absence of federal regulation.

But many restrictions on wind and solar energy were also initially described as temporary. Officials have still renewed them year after year in order to avoid dealing with a controversial issue.

Even when local moratoriums do not always kill projects, they can ensure that an already troubled project gets the boot.

Last year, the housing developer Deltona Corp. sought to build a 1,300-acre data center campus roughly 50 miles north of Tampa. Citrus County commissioners passed a 12-month moratorium on new data centers, but that law didn’t apply to the proposal, which was already pending and therefore exempt.

But when the county planning commission rejected a rezoning proposal for the site months later, it effectively killed the proposal, which could not file a new application without becoming subject to the moratorium.

“The people are not ok with this and clearly some, if not all, of the commissioners are also not ok with this,” Holly Davis, a county commissioner, told the local paper at the time.

Even relatively small data centers can face obstacles. After the University of Michigan bought 120 acres in a light-industrial area of Ypsilanti Township, Michigan, to build a data center, local residents — and municipal officials — vowed to battle the project.

Residents worried about the data center’s energy use, noise levels, environmental impact and its potential security risks. (The facility will be run with Los Alamos National Lab.) But the facility, at its largest, will demand 110 megawatts of electricity — much smaller than most artificial intelligence data centers.

“There’s literally not a conversation that I have, not a stop that I make, where data centers and AI don’t come up,” Abdul El-Sayed, a Democratic candidate for Michigan’s U.S. Senate seat, said earlier this month. He has not endorsed a data center moratorium, but has said projects should have mandatory “terms of engagement.”

The public’s turn against data centers has been swift. In just nine months, Americans swung 49 points against supporting a data center in their area, according to Heatmap Pro polling from the spring. Other polls have shown similar shifts.

A majority of Republicans, Democrats, and independents now say they would oppose a data center proposal in their area.

Yet even with the new surge of bans, most of America remains open — to some degree — for business. More than 90% of counties nationwide have not banned or significantly restricted data centers.

“I don’t think we’re anywhere close to a breaking point yet,” Freed said. “It’s still a big country.”

🔒

You’ve reached your free article limit

Subscribe to Heatmap News for unlimited access to daily energy and climate coverage.
To continue reading
Create a free account or sign in to unlock more free articles.
or
Please enter an email address
By continuing, you agree to the Terms of Service and acknowledge our Privacy Policy
AM Briefing

Greenland’s Green Light

On Alaska power lines, First Solar, and Starbucks’ ESG retreat

Greenland.
Heatmap Illustration/Tanbreez Mining

Current conditions: Cold air is sweeping into the American Northeast after a brief blast of summer-like heat that drove temperatures in New York City up to 85 degrees Fahrenheit last week • Hurricane Nolo crossed the International Date Line, officially becoming Typhoon Nolo • The heat wave roasting Southern California is straining the grid, causing outages for more than 23,000 people in the Los Angeles area.


THE TOP FIVE

1. Greenland approves one of the biggest rare earth mines outside China

Greenland’s government on Monday approved the mining and decommissioning plans for Critical Metals’ Tanbreez rare earths project, which Mining.com described as one of the world’s “larger undeveloped heavy rare earth projects outside China.” The preliminary economic analysis for the mine pegged its total value at $2.1 billion, with an estimated initial capital cost of $290 million. “Approval of the Mining and Closure Plans is a defining milestone for Tanbreez and for Critical Metals Corp.,” Tony Sage, the chairman and chief executive of Critical Metals, said in a press release. “It gives us a clear framework through 2050 to responsibly develop one of the world’s largest heavy rare earth deposits, in partnership with the government of Greenland and the communities of South Greenland.”

Keep reading...Show less
Green
Climate Tech

Exclusive: Blaze Energy Raises $6.5 Million for Low-Carbon Shipping Retrofits

The startup’s system builds on a vessel’s existing engine and makes it effectively fuel-agnostic.

Shipping.
Heatmap Illustration/Getty Images

The shipping industry has a dilemma. The European Union and other jurisdictions are increasingly requiring vessels to cut their carbon emissions, pushing shipowners toward lower-carbon fuels and away from traditional bunker fuel or diesel. But it’s still anybody’s guess which cleaner fuel — ammonia, methanol, or liquified natural gas — will prove most economical and efficient at scale. That leaves shipowners facing an uncomfortable choice: They must decide on a technology around which to build new engines and retrofit existing ones without knowing whether the fuel they bet on today will still be the best option a few years from now.

Blaze Energy says that its product will eliminate that choice. The startup, which announced a $6.5 million seed round on Tuesday — is making a compact fuel “reformer,” a device that uses a heated catalyst to split various alternative fuels into a hydrogen-rich gas. That gas can then be combined with the original fuel and conventional shipping fuel to power existing engines. With Blaze’s bolt-on retrofit, which the startup aims to make less than a tenth the size of the engine itself, shipping companies “can adjust their assets based on how the global energy landscape, regulation, as well as their company direction is changing,” the company’s CEO and co-founder, Rok Sitar, told me. For example, maybe LNG looks cheapest in the short term given its established supply chain, but ammonia could win out down the road.

Keep reading...Show less
Blue
Daily Briefing

Rivian Rolls to a New Record Quarter

The global vehicle market is splitting into two — with just a few exception.

RIvian assembly.
Heatmap Illustration/Rivian

The past three months have been crucial for Rivian, America’s biggest all-electric car company not run by Elon Musk.

The California-based automaker debuted the R2, its long-awaited and somewhat more affordable sport utility vehicle. (Our reviewer gave it high marks.) Rivian also formally took out a nearly $6.6 billion loan from the Department of Energy to finance its new Georgia factory. And it finally unveiled the plans for that facility, which will include a rail tie-in and a 1,000-acre preserved woodland.

Keep reading...Show less
Blue
