Exclusive: Local Opposition to Data Centers Explodes in 2026

The number of data centers canceled after pushback set a record in the first quarter of the year, new data from Heatmap Pro shows.

•
Peeling off a data center.
Heatmap Illustration/Getty Images

Data centers are getting larger and larger. But even so, few are as large as the Sentinel Grove Technology Park, a proposed data center near Port St. Lucie, Florida.

The proposed facility — which became known as Project Jarvis — was set to be built on old agricultural land. It would use up to 1 gigawatt of electricity, enough to power a mid-size city, and bring in up to $13.5 billion in investment to the county.

The project was immediately controversial. But its developers anticipated issues: They would build their own self-contained, self-provided water facilities to service the project, and they agreed to set its 60-foot buildings back far enough from the road so that they couldn’t be seen by drivers.

It wasn’t enough. The project lost a key vote in the planning board in October. And in February, Project Jarvis’s developers withdrew their land use application entirely after Governor Ron DeSantis proposed AI regulation in the statehouse.

The facility was the largest data center project canceled after facing opposition in the first quarter of 2026. But it wasn’t the only one.

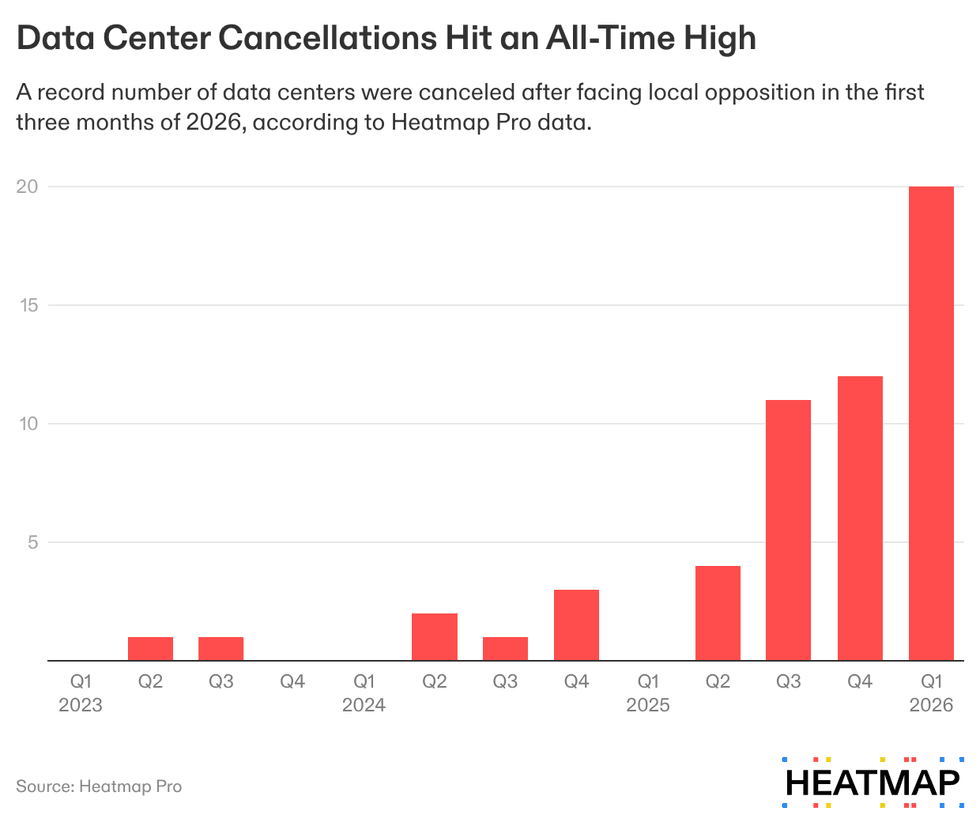

At least 20 proposed data center projects were canceled after local pushback during the first three months of 2026, smashing a record set only in the previous quarter, according to a review of press accounts, public records, and project announcements conducted by Heatmap Pro.

These canceled projects accounted for more than $41.7 billion in investment and represented at least 3.5 gigawatts of electricity demand.

The cancellations reveal the rapidly expanding backlash to data center construction has not yet peaked. From Georgia to Pennsylvania, locals have rebelled against newly proposed data centers, even when the planned facilities are not planning to run artificial intelligence models.

If anything, fights over data centers are surging now. Heatmap Pro’s researchers added roughly 100 new data center fights to their database during the first three months of the past year, a new record.

These fights are succeeding in terminating projects. Last year, roughly 25 data center projects were canceled nationwide after facing some type of local opposition, according to Heatmap Pro data. The country is likely to break that record in 2026 over the next few weeks, our data suggests — only five months into the year.

At least $85 billion in data center projects have been canceled over the past three years, according to Heatmap Pro data.

These numbers haven’t been previously reported. Over the past year, researchers at our intelligence platform Heatmap Pro have conducted a comprehensive national survey of local opposition to data center construction. They have regularly called every U.S. county to tally data center cancellations and any new rules limiting data center construction.

This data is normally available to companies and individuals who subscribe to Heatmap Pro, but we periodically publish a high-level summary of this data. We last released our results in January.

Green
🔒

You’ve reached your free article limit

Subscribe to Heatmap News for unlimited access to daily energy and climate coverage.
To continue reading
Create a free account or sign in to unlock more free articles.
or
Please enter an email address
By continuing, you agree to the Terms of Service and acknowledge our Privacy Policy
AM Briefing

‘Starting to Fray’

On Greenland’s deepsea mining ban, Indonesia floating nuclear, and a solar boom

Data center construction.
Heatmap Illustration/Getty Images

Current conditions: Hurricane Trudy has weakened from its peak as a Category 2 storm but still threatens up to 8 inches of rain as it swirls off Baja California • A nor’easter is howling through the Mid-Atlantic this week, hammering the coast with winds of up to 70 miles per hour • A humid overcast has settled over Paris this week as French authorities struggle to regain control after protests over living costs gave way to anarchic riots.


THE TOP FIVE

1. America’s AI infrastructure boom ‘is starting to fray’

At least 47 major data center projects have been delayed, withdrawn, or blocked so far this year, according to data the regulatory intelligence service RegLayer shared with the Financial Times — and that may be a “conservative estimate.” Just 35% of planned data centers are “credible,” analysts told the newspaper, as more than 1,000 communities across the United States now have restrictions on artificial intelligence infrastructure. The data comes as investors look increasingly jittery about AI following ChatGPT-maker OpenAI’s missing a key revenue metric this year.

Keep reading...Show less
Blue
Spotlight

A Giant Data Center Offers a Permitting Reform Test Case

What would happen to Project Jupiter if the Bipartisan American Affordability and Jobs Act is passed?

Project Jupiter.
Heatmap Illustration/Project Jupiter, Library of Congress

One of the nation’s largest data centers is struggling under permitting woes. So let’s play a game: would the bipartisan permitting bill in Congress make the path easier, or might the federal legislation be irrelevant to large hyperscalers under development today?

Meet Project Jupiter, a mega project in southern New Mexico in Dona Ana County under development by Oracle and OpenAI, with financial backing from SoftBank and political support from the Trump administration for being a part of Stargate, a major Trump administration public-private initiative boosting AI development. Project Jupiter would be one of the largest data centers in the country if completed and currently is expected to run on a microgrid powered by fuel cells converting gas to electricity, which the developers claim will burn much cleaner than a typical off-grid gas turbine power plant.

Keep reading...Show less
Yellow
Hotspots

The Trump Administration Is Still Messing with Offshore Wind Farms

And more of the week’s top news around project fights.

The United States.
Heatmap Illustration/Getty Images

1. New England (and Maryland) – The Trump administration is still messing with offshore wind farms, even while trying to pass a permitting reform deal. Examining the court filings reveals why they may feel empowered to do it — and I’m not sure how this ends.

  • Last Friday, in a legal case brought by anti-wind activists, the Justice Department submitted a motion in federal court to send the construction and operations plan for Orsted’s Revolution Wind project in New England back to the Interior Department for more analysis. On Wednesday, the DOJ entered a similar motion in another case challenging the construction and operations plan for U.S. Wind’s MarWin project off the coast of Maryland in a lawsuit brought by the state’s coastal community of Ocean City.
  • Trump’s actions led some to question whether the president was sabotaging the deal, and others to claim the media coverage itself was an attempt to kill it. Going further, supporters of the bipartisan bill claimed the DOJ's motions were precisely why the bill should become law, implying it would guard offshore wind farms against this sort of maneuver.
  • However, for the bill’s backers, it’s worth considering why the Trump administration believes it has the legal authority to do this. It’s also time to ask whether the bill would actually protect these wind farms against this tactic.
  • To answer those questions, you have to rewind. On May 1, 2025, the Interior Department withdrew a Biden solicitor’s opinion instructing the agency to “strike a rational balance” between wind power and fishing interests. This revocation document is technically not in effect at the moment; one year later, a federal court ruled the opinion was potentially illegal as a part of a preliminary injunction on five anti-renewables actions requested by solar and wind trade groups. The Trump administration is contesting that ruling, and the administration has filed a notice of appeal.
  • In August, despite that opinion being in doubt, a federal judge granted Trump permission under the Outer Continental Shelf Lands Act to remand the construction and operations plan for the now-defunct Atlantic Shores offshore wind farm in the waters of New Jersey. U.S. District Judge Jia Cobb specifically wrote that Atlantic Shores failed to demonstrate the federal government had limitations under OSCLA on revisiting these plans and that the injunction from the litigation on appeal “did not prohibit all reevaluation of agency action.”
  • In the recent Revolution and MarWin filings, Trump’s Justice Department argues the construction and operations plans should be remanded under OSCLA without being vacated. The DOJ motions include claims that previous decision documents did not adequately explain impacts to commercial fishing and other industries that use OSCLA waters. It’s not clear if the administration will win these motions.
  • The bipartisan permitting bill would bar the Interior Department and other federal agencies from taking “any new action that would revoke, rescind, withdraw, terminate, suspend, amend, or alter a federal authorization or permit in effect on or after September 16, 2026,” or “any other action to interfere with or prevent the construction or operation at full capacity of a project that has secured all necessary federal authorizations and permits.” The restriction exempts cases where “the agency is required to take such action by order of a court.” As I wrote in our lengthy piece explaining the bill, this provision has a damages component that allows companies impacted by violations to pursue financial compensation.
  • Here’s the billion-dollar question I expect we won’t have answered unless the bill language is enacted and then litigated: Would the court order exception apply to rulings that grant these motions? Or would the developers be able to sue for damages?

2. Columbia County, N.Y. – New York’s renewable energy permitting office has rejected an upstate solar farm on farmland as a House Democrat representing the area joined hands with the Trump administration in publicly railing against the project.

Keep reading...Show less
